Steel Structure Assembly Building

Steel Structure Assembly Building

A steel structure assembly building is not built on-site — it is assembled. Every H-column, primary beam, and roof purlin is shop-fabricated to ±0.5 mm tolerance from Q355B high-tensile steel, shot-blasted to Sa2.5, then coated to DFT ≥ 250 μm before it leaves our Shenyang facility. On your site, crews only bolt. 10.9-grade high-strength bolts. No field welding. No coating repairs. A 3,000 m² clear-span shell reaches roof-tight in 35–45 days, verified across 42 projects delivered under ISO 9001 and CE since 2019.
Send Inquiry

Shenyang Zishenlong Light Steel Color Plate Co., Ltd. is one of the most reliable manufacturers and suppliers of steel structure assembly building in China, also supports customized service. Welcome to buy CE and ISO approved steel structure assembly building at low price from our factory.



 Night large steel structure assembly building realistic industrial photography magnificent steel frame construction with surrounding landscape lighting

WHY "ASSEMBLY" IS A DIFFERENT CATEGORY

Most buyers searching for "steel structure buildings" are quietly asking one question:

"Will I still be paying welders in month four?"

With a conventional welded steel frame, the answer is often "yes" - crews chase weld defects, wait for NDT sign-off, patch primer that burned off in the heat-affected zone, and slip your fit-out by weeks.

A steel structure assembly building answers with a flat "no". Every load-transferring joint is designed as a bolted moment or shear connection. Every column, beam, brace, purlin, and girt is drilled, primed, and match-marked in our factory, then packed in the assembly sequence your crew will use. Your project becomes a kit build, not a construction project.

Buyer takeaway: You are not hiring a steel contractor. You are receiving a manufactured product with an assembly manual.



WHAT'S INSIDE THE KIT - CORE ENGINEERING SPECS

System ZSL Delivered Spec Why It Matters to You
Primary frame H-section, Q355B (fy ≥ 345 MPa) 22% lighter than Q235 for the same load - direct saving on freight and foundation
Fabrication tolerance ±0.5 mm on hole spacing, ±1.0 mm on member length Bolts drop into place - no on-site drilling, no rework
Connection type 10.9-grade high-strength bolts, end-plate & gusset design Verified rigid moment transfer; no field welding, no NDT
Column spacing 6 m / 7.5 m / 9 m standard, clear-span up to 48 m Column-free operating floor - pick your equipment layout, not ours
Eave height 6 m – 15 m single-story; multi-story on request Full compatibility with racking, cranes (up to 20 t), mezzanines
Roof & wall system 0.5 mm PVDF-coated standing seam roof + PIR/PU sandwich panels (50–100 mm) 25-year color retention; U-value down to 0.35 W/m²K
Corrosion protection Sa2.5 shot-blast → epoxy-zinc primer → DFT ≥ 250 μm ISO 12944 C4-High durability - 15+ years without repaint in industrial atmospheres
Design load capacity 42 m/s basic wind (Vb, EN 1991-1-4), 1.5 kN/m² snow, seismic 8-degree Meets or exceeds most target-market building codes
Certifications ISO 9001 (QMS), CE (EN 1090 EXC2/EXC3) Bankable for FDI-grade projects, insurance-friendly



THE FOUR-STAGE ASSEMBLY WORKFLOW (4P)

  •  Pre-Build - Where Your Steel Tonnage Actually Gets Decided

We do not accept vague RFQs. Before the first plate is cut, our detailing team produces:

  1.  Shop drawings (Tekla / SDS2), stamped by our in-house structural engineer
  2.  Variable-section optimization: tapered web plates on primary frames typically cut 8–14% off tonnage vs. constant-section design
  3.  Bill of Materials cross-checked to your logistics constraint (40 HQ container? Open-top? Break-bulk? We pack accordingly)
  4.  Erection sequence pack: every member numbered, matched to a lift order, so your crane hook path stays productive

 What we don't do: foundation design and anchor-bolt embedment - that is your civil contractor's scope, and we deliver a certified anchor bolt template so their work locks in with ours.

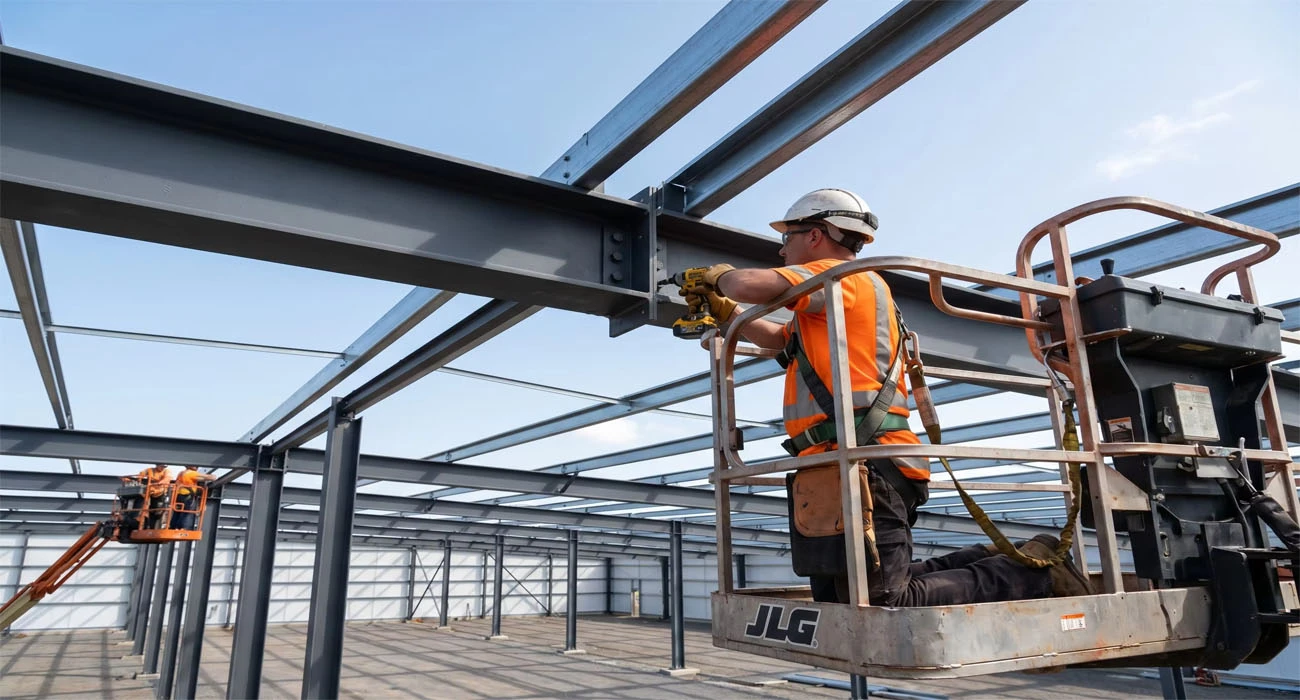

Steel structure assembly building site erection ironworker tightening high-strength bolts on roof purlin battery torque wrench zero field welding bolted steel frame construction

  •  Process - Six Factory Checkpoints Before Anything Leaves Shenyang

1. Plate receiving - mill test certificates (MTC) verified for every Q355B batch
2. CNC cutting & drilling - hole positions machined, not marked by hand
3. Sub-assembly welding - indoor GMAW/SAW, UT inspection on all full-penetration welds
4. Shot-blasting - Sa2.5 grade, dust-free chamber
5. Coating - three-coat epoxy-zinc + intermediate + polyurethane top; DFT gauged every 10 m²
6. Match-fit trial assembly - every rigid frame is bolt-checked flat on shop floor before packing

Every kit ships with a QA passport- traceable to plate heat number, welder ID, and coating batch.



  •  Performance - What Happens on Your Site
  1. Zero field welding. Zero grinding sparks near your finished panels.
  2. Zero primer repair. The shop coat arrives intact under our shrink-wrap protection.
  3. Predictable erection rate: a trained 6-person crew + 1 crane completes **200–300 m² of steel frame per day for standard-span buildings.
  4. Roof-tight in 35–45 days for a 3,000 m² single-story shell - verified across projects in Saudi Arabia, UAE, Chile, Guyana, and Australia.

Chinese engineers deliver completion documents to Middle Eastern client

  • Proof - What You Get When It's Done

Not "we're finished, goodbye." You receive a project close-out file:

  1. As-built drawings (PDF + DWG)
  2.  MTCs for every steel batch
  3.  Coating DFT logs
  4. Bolt torque records
  5.  ISO 9001 & CE conformity declarations
  6. 10-year structural warranty, 5-year roof/wall panel warranty

 This file is what your insurance underwriter and future valuer will ask for. Buildings with complete engineering close-outs typically appraise 6–12% higher than those without.



WHERE STEEL ASSEMBLY BUILDINGS OUTPERFORM ALTERNATIVES

Requirement Concrete Frame Welded Steel (Site-Fabricated) ZSL Assembly Building
Time from PO to roof-tight (3,000 m²) 5–7 months 3–4 months 1.5–2 months
Site labor peak headcount 40–60 25–35 8–12
Field welding required N/A Extensive, requires certified welders on-site None
Foundation load High (heavy deadweight) Medium Low - up to 40% lighter
Ability to disassemble & relocate No Very limited Yes - bolted joints are reversible
Insurance / bank valuation Standard Standard Premium (documented QA trail)



 TYPICAL APPLICATIONS WE'VE DELIVERED

- Light industrial workshops (machinery, textile, food processing) - 1,000–20,000 m²
- Distribution & 3PL warehouses with clear-span up to 36 m
- Cold storage shells paired with PIR panels, U ≤ 0.28 W/m²K
- Modular office/administration blocks on the same bolted platform
- Agricultural & poultry buildings where corrosion resistance is non-negotiable

Recent references (available on request under NDA):
- Riyadh, Saudi Arabia - 15,000 m² single-span workshop, roof-tight in 45 days
- Georgetown, Guyana - 4,800 m² coastal warehouse, C5-M coating spec for salt exposure
- Perth, Australia - 2,200 m² light industrial hall, AS/NZS 1170 wind-load compliant



FAQ

  • Q1. Do you handle the foundation?

No - foundations are your civil contractor's scope. We deliver a certified anchor bolt setting-out plan and a template ring so their concrete pour interfaces exactly with our steel. This is the cleanest interface in the industry.

  • Q2. Our project uses AISC / Eurocode / AS-NZS. Can you design to those codes?

Yes. Our engineers design to GB 50017, AISC 360, EN 1993 (EC3), and AS 4100 depending on your project code. Certification packages (CE / EN 1090 EXC2) are available for European and Middle-Eastern projects.

  • Q3. What is included in the price? What is not?

Included: shop drawings, all steel members (primary + secondary + bracing), high-strength bolts, roof/wall panels, gutters/downpipes, standard doors/windows, marine packing.
Not included: foundation, ground floor slab, MEP (unless quoted separately), on-site erection labor (we can send a supervisor).

  • Q4. Can you send a supervisor for erection?

Yes. Our field engineers have supervised projects across 14 countries. Two supervisors on-site typically cover a 5,000 m² project through to roof-tight.

  • Q5. Lead time?

Standard 30–45 days from approved shop drawings to FOB. Add 25–45 days shipping depending on destination. Total FOB-to-erection-complete window: 90–120 days.

  • Q6. Minimum order?

We accept single-building orders from 100 m². Below that, we recommend our container-based product line instead.
